Key Dates

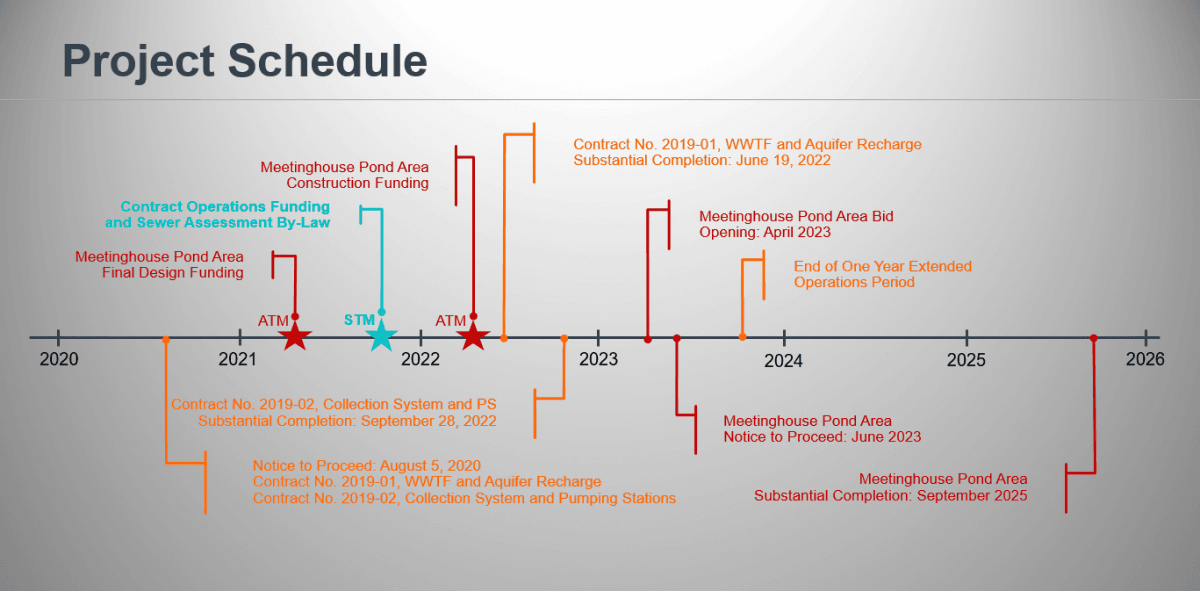

Project Schedule

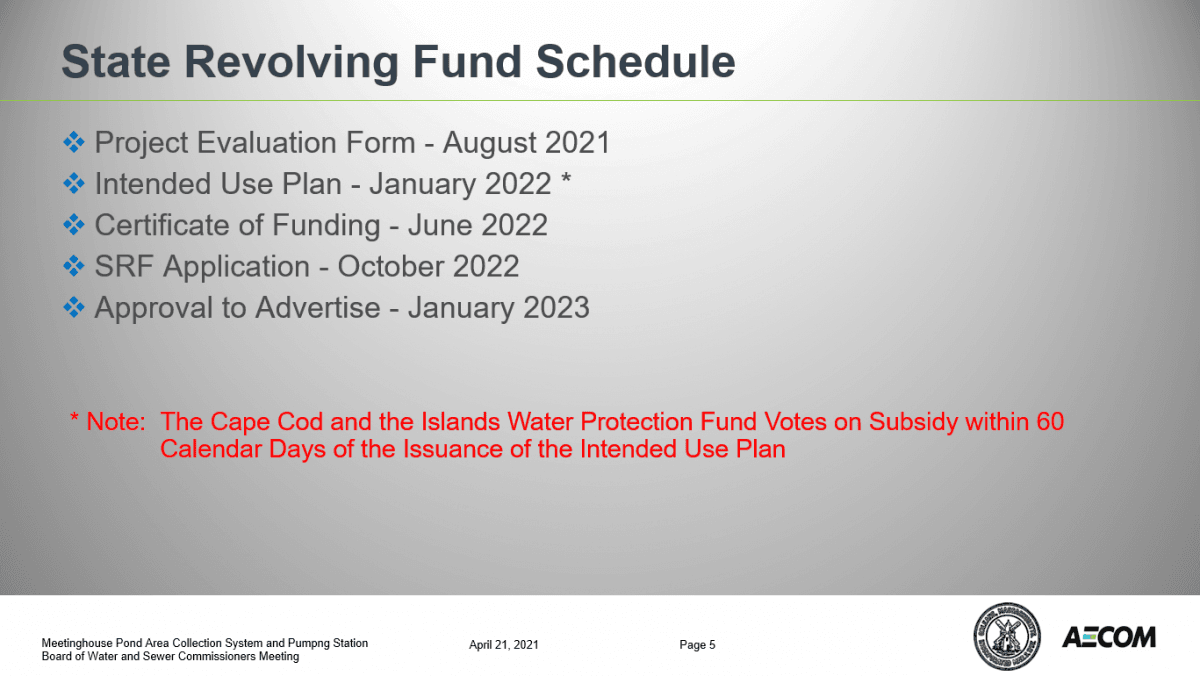

State Revolving Fund Schedule
